Buc-ee's in Stafford County: Planning Commission Approves 74K Sq Ft Travel Center in 4-3 Vote
After more than two years of delays, deferrals, heated public hearings, and 86 VDOT comments on the traffic plan, the Stafford County Planning Commission voted 4-3 on March 26, 2026 to recommend approval of Buc-ee's proposed travel center off I-95 at Exit 140.
The project now heads to the Board of Supervisors for a final vote. No date has been announced yet, but the Board has the final say on whether this actually gets built.
Here's where things stand and what you need to know.
What Just Happened
The Planning Commission hearing on March 26 drew more than 40 speakers. The community is deeply divided. Residents from Embrey Mill and Austin Ridge showed up in force against it, while supporters pointed to the $1.9 million in annual tax revenue and 200 jobs.
County planning staff actually recommended denial of the project, citing unresolved traffic impacts and concerns about fuel canopy lighting affecting nearby residential areas. But the commission voted to send it to the Board of Supervisors anyway.
Commissioner Kelsey Caudill, who made the motion to approve, said it plainly: "This has been an ongoing process, and to work out those things with VDOT could take months. I think we need to get it to the Board so they can work out proffers. I think the Board is ready to look at this project."
Commissioner Gregory Goldstein, who represents the Garrisonville District where the Buc-ee's would be located, actually pushed for another deferral, citing "unanswered questions" about traffic, nearby businesses, and property values. He was outvoted.
What Buc-ee's Is Proposing

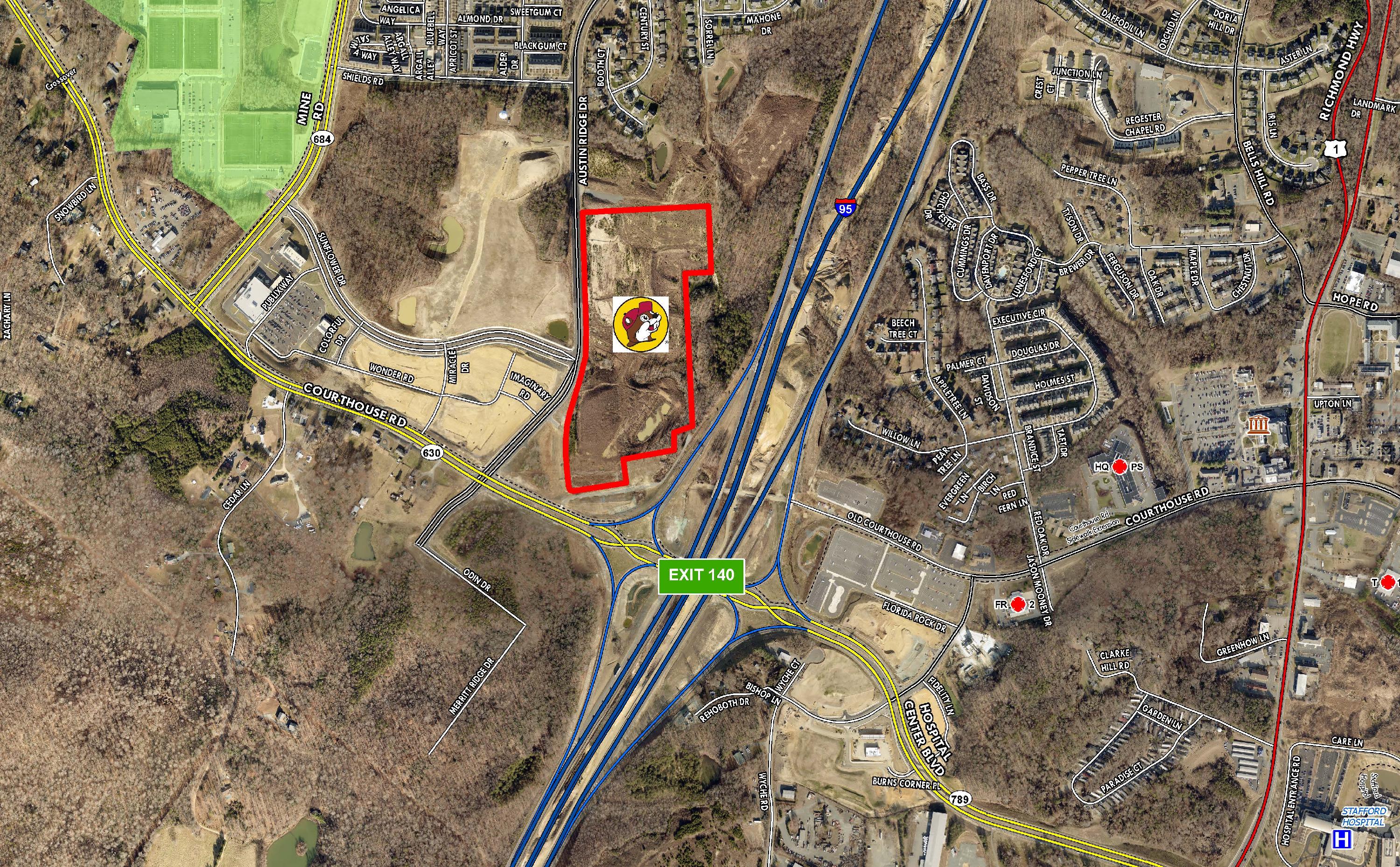

- Location: 36+ acres at Courthouse Road and Austin Ridge Drive, off I-95 Exit 140
- Building: 74,000 sq ft, single story, 38.5 feet tall
- Fueling: 60 gas islands (120 fueling positions)
- Parking: 833 spaces, including 24 Tesla Superchargers, 12 RV/bus spaces, 24 ADA-accessible spots
- Jobs: Estimated 200 positions with $16-$19/hr starting pay and full benefits
- Revenue: Estimated $1.9 million annually in general fund revenue plus additional gas tax revenue
- Truck traffic: Tractor-trailers will be prohibited at this site
- Hours: 24/7 operation
- Signage: 45-foot-tall monument sign near I-95 and three 285 sq ft wall signs
- Open space: 39% open space (exceeds the 30% requirement), 60-foot buffer along I-95, 15-foot evergreen screening buffer along future Israel Rodriguez Drive
The Traffic Situation
Traffic has been the central issue from day one and it still isn't fully resolved. The developer's Traffic Impact Analysis estimates 20,940 vehicle trips per day, with more than 2,100 during peak weekend hours.
Here's what VDOT and county engineers have flagged:
- Traffic would back up onto I-95 from the Courthouse Road ramps during peak times
- Several local intersections would degrade to Level of Service F
- VDOT issued 86 comments on the original traffic analysis
- An Operations and Safety Analysis Report (OSAR) with the Federal Highway Administration is required because the project modifies Exit 140 - that process takes 18-24 months
Buc-ee's has committed to significant road improvements:
- A dedicated new lane off the southbound I-95 ramp that bypasses the Courthouse Road/Austin Ridge intersection entirely
- Widening Austin Ridge Drive to add three exclusive southbound left-turn lanes
- An additional westbound through lane on Courthouse Road
- New traffic signals at Buc-ee's Boulevard and Sunflower Drive
- Dual right-turn lanes and extended left-turn storage at Courthouse and Austin Ridge
- Optimized signal timing across the corridor
Buc-ee's development director Stan Beard told the commission: "The worst thing we could ever do is build a store with a traffic problem." The company has proffered a legally binding commitment to mitigate whatever impacts the federal OSAR process identifies as their responsibility.
County staff still noted that even with all proposed improvements, some intersections - particularly Austin Ridge Drive and Courthouse Road - would face significant delays during weekend peak periods.
Why Embrey Mill Is Leading the Opposition

Most of the opposition is coming from residents in Embrey Mill and Austin Ridge, the large communities right next to the proposed site. Many have contacted me directly on Instagram to share concerns about traffic backups on Austin Ridge and Courthouse Road, light pollution from gas station canopy lights, and safety and noise from 24/7 operation.
A Change.org petition titled "Stop Buc-ee's from coming to Stafford, VA" has more than 2,000 signatures. At the March 26 hearing, resident Sean Matthews said: "A good neighbor respects the character of a community."
A competing petition supporting Buc-ee's has gathered about 360 signatures, and local business owner Judith May brought a stuffed Buc-ee's beaver to the lectern and argued that the county needs businesses to ease the tax burden on homeowners.
Environmental Hurdles
The site still faces environmental compliance issues that are not fully resolved:
- Wetland delineation is required due to hydric soils and nearby streams
- A Chesapeake Bay Preservation Plan has not yet been submitted
- Stormwater plans are under review - the site must manage runoff from fueling areas
- Water/sewer demand will require major infrastructure buildout: 35,000 gallons/day water and 23,000 gallons/day sewer
Timeline: Where It Stands Now
- Feb 2024: Conditional Use Permit filed
- March 2025: Rezoning application filed
- Oct 2025: Planning Commission defers vote 6-1, VDOT issues 86 comments
- Jan 2026: Deferred again
- March 11, 2026: Planning Commission grants four-month extension
- March 26, 2026: Planning Commission votes 4-3 to recommend approval (county staff recommended denial)
- Next: Board of Supervisors public hearing and final vote - no date announced yet
- If approved: Federal OSAR process takes 18-24 months before construction can begin on the I-95 interchange modifications
Rockingham vs. Stafford: Why One Sailed Through and One Didn't

Buc-ee's opened its first Virginia location in Rockingham County on June 26, 2025, with Governor Youngkin and a full slate of elected officials in attendance. A New Kent County location is expected to open in 2029.
The Rockingham location is nearly identical in size - 74,000 sq ft with 120 fueling positions - but passed quickly due to stronger public support and fewer traffic conflicts. There was no major residential community directly adjacent to the site, and the I-81 interchange didn't present the same backflow-onto-the-highway risk that I-95 Exit 140 does in Stafford.
The Bigger Picture: Growth vs. Livability in Stafford County

The Buc-ee's fight has become a lightning rod for a bigger question in Stafford County: can the region keep growing without overloading its infrastructure and changing the character of residential neighborhoods?
This isn't just about a gas station. It's about how Stafford handles rapid commercial expansion near communities like Embrey Mill. The Planning Commission's 4-3 vote shows just how divided the answer is. And now the Board of Supervisors gets the final call.
Frequently Asked Questions
Has Buc-ee's been approved in Stafford County?
Not yet. The Planning Commission recommended approval 4-3 on March 26, 2026, but the Board of Supervisors still needs to vote. No date has been announced.
Where is it proposed?
At the corner of Courthouse Road and Austin Ridge Drive in Stafford, VA, off I-95 Exit 140.
How big is the project?
One building, 74,000 square feet. It includes 120 fueling positions and 833 parking spaces.
Is this a truck stop?
No. Tractor-trailers will be prohibited. The site is designed for cars, SUVs, buses, and RVs only.
How much traffic will it generate?
Roughly 20,940 trips per day, with more than 2,100 during peak hours.
What's the concern with traffic?
VDOT and county engineers have flagged backups onto I-95 off-ramps and failing grades at nearby intersections. VDOT issued 86 comments on the traffic plan.
Are any improvements required?
Yes. Buc-ee's must fund intersection upgrades, signal timing changes, lane expansions, a new bypass lane off the I-95 ramp, and complete a federal OSAR process that takes 18-24 months.
Are there environmental concerns?
Yes. Wetlands, stormwater runoff, and Chesapeake Bay Act compliance are all still under review.
How many jobs will Buc-ee's create?
Roughly 200 local jobs, starting at $16-$19/hr, plus benefits and 401(k).
How much tax revenue would it generate?
An estimated $1.9 million annually in general fund revenue plus additional gas tax revenue.
When might a final decision be made?
The Board of Supervisors will hold a public hearing and vote, but no date has been set. If approved, the federal OSAR process adds another 18-24 months before interchange construction can begin.
